Basement Renovations Auckland: A Complete Planning Guide
Consent, the order of works and the waterproofing checks to do first, from the LBP team at Auckland Waterproofing Experts
Many of the basement jobs we look at in Auckland start the same way. Someone stands under the house with a torch, looks at the block walls and the bare slab, and pictures a spare bedroom, an office or a rumpus room for the kids. That picture is the easy part. The planning behind basement renovations in Auckland is what decides whether the room ends up warm, dry and signed off, or becomes a job you redo in three years.
We’re Auckland Waterproofing Experts, an LBP team that works under houses, in garages and behind retaining walls across Auckland. On a conversion, our part is the waterproofing that has to be right before anyone else starts. This guide walks through the order we’d plan a conversion in, and the questions worth asking before you spend anything.
Why basement renovations make sense in Auckland
Plenty of Auckland homes, especially older villas and bungalows on sloping sections, sit on a lower level that’s only used for storage, a workbench or a car. Using that space well can give you another room without extending the footprint of the house or losing garden.
The catch is simple. Anything below ground is in contact with damp soil, and water moves downhill towards your walls every time it rains. A below-ground room only works if the walls and floor keep that water out, so waterproofing sits at the very start of the plan, not the end.
Key points
- Check the space is dry, and find out why if it isn’t, before you design anything.
- Most conversions that create a habitable room need building consent. Check with Auckland Council before you start.
- Waterproofing goes on before linings, insulation and flooring, never after.
- Get a written scope and ask who is signing off each part of the work.
Tidy-up, conversion or dig-down: know which project you have
“Basement renovation” covers very different jobs. Working out which one you’re planning tells you who needs to be involved and what paperwork to expect.
A tidy-up of existing space
This is sealing a slab, treating damp walls, tidying up the lighting and using the space for storage, a workshop or a laundry. Some low-risk work is exempt from building consent under Schedule 1 of the Building Act, but the owner is responsible for deciding whether work is exempt, and exempt work still has to comply with the Building Code. If you’re not sure, MBIE’s guidance on checking whether you need consents is the place to start, or ask the Council.
A habitable conversion
Turning the space into a bedroom, office or living area is a different project. Once people are going to live in the room, it has to meet the Building Code for a habitable space. That brings in things like moisture, ventilation, natural light, insulation and fire safety, and usually building consent. This is where a designer or architect earns their fee: they draw the layout, specify the waterproofing in the consented plans and deal with the Council.
A dig-down or excavation
Lowering the floor or digging out to gain height changes the structure of the house. MBIE lists structural alterations and some earthworks among the work that needs a consent, and the Council can tell you whether district or regional plans also mean you need a resource consent. Expect a structural engineer, and often a geotechnical report, before the design is settled. Excavating beside existing foundations is not a DIY job.
If you’re unsure which category you fall into, sort that out first. It shapes everything that follows, from the budget conversation to who you call next.

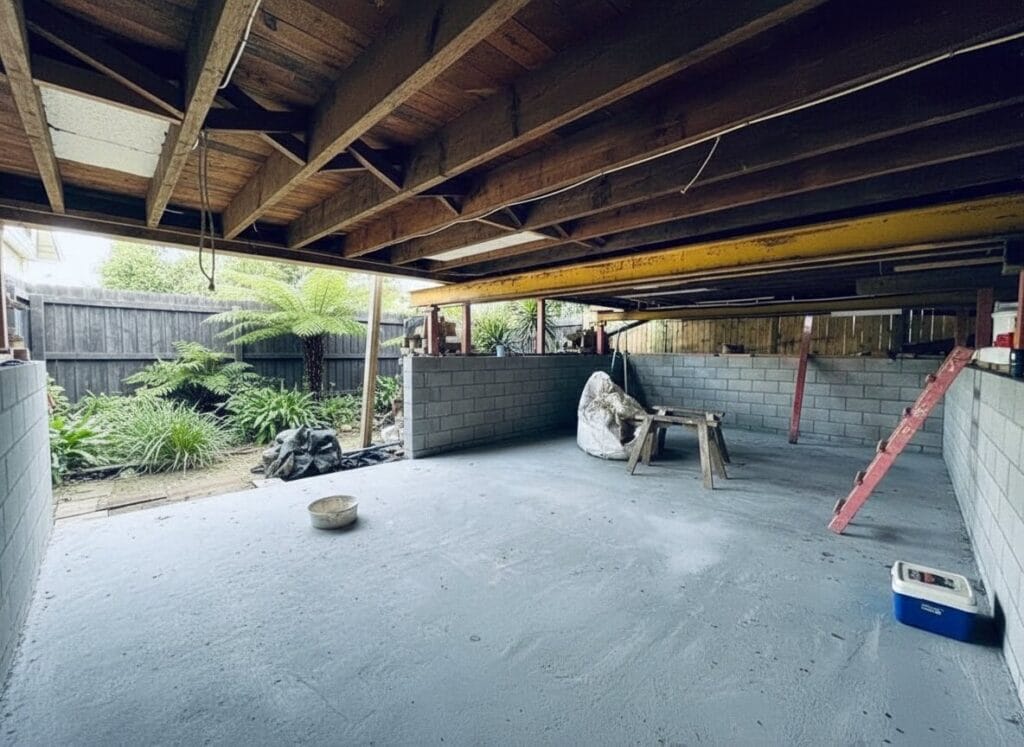

Before you start, check it’s dry
There’s no point designing a room in a space that leaks. Spend a wet week looking around before you talk to a designer. Our guide to the early signs of a basement leak goes into more detail, but these are the ones we look for first:
- Damp patches or cold spots on the lower parts of the walls, especially on the uphill side.
- Chalky salt deposits (efflorescence) on block or concrete. They show water has been moving through the wall.
- Peeling paint, bubbling coatings or stained timber at the base of the walls.
- A damp smell with no visible water. It’s worth checking behind linings.
If you find any of these, find the cause before you plan the fit-out. We do basement leak repair across Auckland, and we’ll tell you honestly whether the space is ready to be converted. For an example of the work, here’s a basement wall we sealed from the inside in Parnell.

Auckland’s below-ground challenges
Auckland gets a lot of rain, and much of the city is built on clay that holds water rather than draining it. On sloping sections, runoff from higher ground collects against the uphill wall of a basement. Many older homes were built before subsoil drains were standard, and some still have the original block walls with no membrane on the outside.
As a city gets denser, there are more driveways, patios and neighbouring buildings sending stormwater your way. None of this rules out a conversion, but it’s why we look at the whole site, not just the wall that shows a stain. Where the outside of a wall can be dug out, below-ground tanking from the outside is one option. Where it can’t, the wall is waterproofed from the inside.
Consent and the Building Code
Do you need building consent?
In most cases, yes. A basement renovation usually needs building consent from Auckland Council when it involves:
- Structural changes, such as removing or altering walls or adding rooms
- Significant plumbing or drainage alterations
- Creating new habitable rooms from non-habitable space
- Changes to the building envelope or weathertightness
- Any work affecting fire safety or structural integrity
Building consent fees in Auckland typically range from $2,000 to $10,000+ depending on project scope. Factor in engineering reports ($2,000–$5,000+) and council inspections when budgeting. These are typical Auckland market estimates, excl. GST.
Always check with the Council for your own property before work starts.
Building Code clause E2: external moisture
Clause E2 of the Building Code requires buildings to resist the penetration and accumulation of moisture from outside. Walls, floors and structural elements in contact with the ground must not absorb or pass on moisture in a way that causes dampness or damage. For a basement, that means the waterproofing has to be designed in, not added later.
Paperwork to keep
On a consented job, keep these documents together. You’ll need them for the Code Compliance Certificate (CCC), and you’ll want them when you sell:
- The consented plans, including the waterproofing specified for walls and floor
- A producer statement (PS3) for each membrane, signed by the applicator and backed by photos and tests. Without it, the CCC can stall.
- Product information for the membranes used. Ask your contractor for the product’s CodeMark certificate or appraisal, if it has one.
- Records of work from the licensed people who did any restricted building work. Our post on the LBP licence explains where waterproofing currently sits.
- Photos of the waterproofing before it was covered
- Written warranties. Ask your contractor what covers the product and what covers the workmanship, and get both in writing.
- The Code Compliance Certificate once the Council signs the job off
The basement renovation process, step by step
1. Assessment
- Look at drainage, soil, ground levels and where water comes from in heavy rain
- Find any cracks, cold joints or failed coatings, and the source of any moisture
- Photograph the space as it is now
2. Design and consent
- Engage a designer or architect for the layout
- Commission engineering reports where the work needs them (structural, geotechnical)
- Apply for building consent from Auckland Council
- Make sure the waterproofing system is specified in the consented plans
3. Preparation
- Excavate outside the walls if external waterproofing is part of the plan
- Clean and repair the surfaces, removing old paint, oil and loose material
- Install or check the subsoil drainage

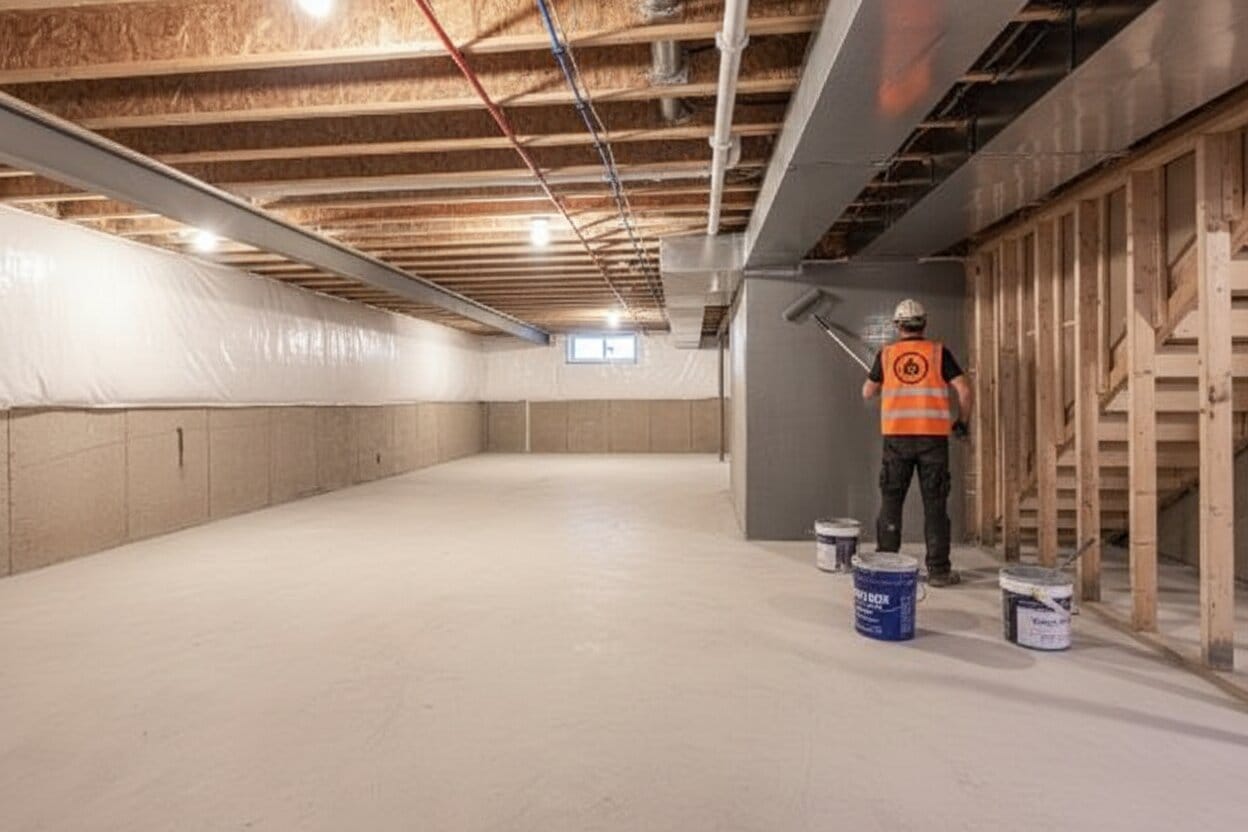

4. Waterproofing
A specialist waterproofs the walls and floor before any framing, linings or flooring go on. This is the part we do; you can read how we approach it on our basement waterproofing Auckland service page.
5. Inspection and testing
- Check the membrane for gaps and weak spots at corners, joints and pipe entries
- Flood-test where required
- Photograph the work for the Council and warranty records
- Book the Council inspection before anything is covered
6. Protection and finishing
- Protect the membrane before other trades start
- Fix insulation and linings in a way that doesn’t puncture the membrane, following the system’s instructions
- Complete the electrical, plumbing and fit-out
7. Final sign-off
- Council final inspection
- Code Compliance Certificate
- Warranty documents and the PS3 filed with your house papers
Basement Renovation Costs in Auckland (2026)
Typical Auckland market estimates, excl. GST. Your own job will depend on the site, access and what you’re building, so treat these as a starting point for budgeting, not a quote.
| Component | Typical Cost Range |
|---|---|
| Full basement conversion | $1,500–$4,000 per m² |
| Total project (complete conversion) | $250,000–$500,000+ |
| Liquid membrane waterproofing | $100–$200 per m² |
| Sheet membrane waterproofing | $150–$300 per m² |
| Interior crack injection/repair | $500–$3,000 per wall |
| Subsoil drainage installation | $5,000–$15,000 |
| Sump pump installation | $2,000–$5,000 |
| Building consent fees | $2,000–$10,000+ |
| Engineering reports | $2,000–$5,000+ |
Why Prevention Pays
A leak found after the fit-out costs more to fix than one dealt with first, because the linings, insulation and flooring have to come out before anyone can reach the wall. That’s why the waterproofing sits at the start of the budget, not the end. Our guide to the hidden costs of water damage goes further, and our waterproofing costs guide covers wider waterproofing pricing.
Layout and finishing
Once the space is dry and the consent path is clear, the design questions are much the same as for any room, with a few below-ground twists:
- Ceiling height. Measure under the beams and pipes, not just the joists. Your designer will tell you what works for the room you have in mind.
- Light. Basements are often dark on the uphill side. Plan where windows, doors or light wells could go early, because they affect the structure and the waterproofing.
- Ventilation. A below-ground room needs a way to move air out, especially if it includes a bathroom or laundry.
- Flooring. Talk to us and your flooring supplier together, so the floor finish suits the membrane on the slab.
Looking after it once it is finished
A converted basement needs a little regular attention, mostly outside:
- Keep the ground and paving falling away from the house
- Keep gutters clear and take downpipes well away from the walls
- Keep any window wells clear of leaves and soil
- After heavy rain, walk around the room and check the bottom of the walls
If you notice a damp smell, chalky marks or a stain that wasn’t there before, get it looked at early. Our guide to a musty smell in your garage covers many of the same moisture paths.
Choosing a contractor
What to look for
- Experience below ground in Auckland. Ask for examples of basement or retaining wall jobs and what they found.
- Photographs at every stage. The Council and your PS3 rely on them.
Questions to ask
- What waterproofing system do you recommend for my site, and why?
- Can you show me similar Auckland basement jobs?
- What warranty comes with the product, and what covers the workmanship? Can I have both in writing?
- Does the membrane have a CodeMark certificate or appraisal?
- Will you photograph the work for the Council records?
- Have you worked with Auckland Council consent requirements on basement jobs before?
Frequently asked questions
Do I need building consent for a basement renovation?
In most cases, yes. Work that alters the structure, creates habitable rooms or changes plumbing or drainage needs Auckland Council building consent. Check with the Council for your property.
Should the waterproofing go on before or after the fit-out?
Before, always. The membrane has to go onto prepared concrete or block. Once framing and linings are up, there’s no proper way to reach the wall.
What’s the difference between tanking and waterproofing?
Tanking means wrapping a below-ground structure in a continuous waterproof barrier. Waterproofing is the broader term for all the ways of keeping water out. Our below-ground guide, linked above, explains tanking in more detail.
Can a garage be turned into a basement room?
Often, yes, but it usually needs building consent and careful waterproofing, plus attention to the garage door threshold and ventilation. See our page on garage waterproofing.
What does a basement renovation cost?
It depends on the space, the access, the condition of the walls and floor, and what you’re turning it into. The costs table above gives typical ranges. Every job is quoted after a free site visit.
Related guides
- A North Shore basement we waterproofed with HydrEpoxy
- Mapei Lamposilex leak repair guide
- Retaining wall waterproofing
- When membrane replacement needs building consent
- B2 durability and waterproofing
Planning a basement renovation? Start with a site visit
If you’re thinking about using the space under your house, we’re happy to come and have a look. We’ll check the walls and floor, tell you what we find and what we’d do, and give you a written quote. We can’t promise miracles, but we can promise to take care with your home and tell you straight.
Call Auckland Waterproofing Experts on 022 630 6434. Site visits are free.
